PATHWAY 04 · LESSON 01

How to calculate care-worker demand and usable capacity

Calculate domiciliary care staffing demand, usable worker capacity, peak-time gaps and skill-mix risks before committing visits to the rota.

Applies to: CQC staffing requirements apply to regulated providers in England. Working-time, contract and employment rules can change how much availability is usable; check the current rules and individual arrangements before relying on a capacity figure.

  • Practical guide
  • 13 min read
  • Reviewed 10 August 2026
  • 6 official sources checked

What this guide covers

  • Choose the planning window and operating area
  • Convert care into worker-hours
  • Add travel and required non-contact work
  • Add a named contingency allowance

Quick answer

Calculate worker-hours of demand first, subtract real constraints from supply, then test the result at the busiest time and for each required skill.

Do not calculate capacity by counting employees or adding contracted hours. Start with the care that must be delivered: the duration, timing, location, travel, double-up requirement, continuity expectation and skills needed for every visit. Then compare that demand with workers who are actually available, rested, competent, authorised and suitable in the same time band and area.

A weekly surplus can still contain a morning shortage, a medicines gap or an uncovered double-up call. Use hours as the first calculation, then test the result by time window, geography, skill and continuity. Keep the assumptions and management decision so the provider can explain why work was accepted, delayed, redesigned or declined.

Care worker discussing a home visit plan with an older woman
Capacity begins with what each person needs, when they need it and who is suitable to provide it. Select the image to inspect it at full size.

Who should use this capacity review

Use it before accepting a new package, publishing a rota or responding to a material change in needs, availability or workforce risk.

  • Registered managers and nominated individuals
  • Care coordinators and rostering leads
  • Workforce, recruitment and learning leads
  • Operations and finance leaders testing sustainable growth
Workforce records and care rota information shown together
A useful capacity view connects availability with current competence, restrictions and the real visit pattern. Select the image to inspect it at full size.

Decision process

Turn care demand into a defensible capacity decision

Use one agreed planning window and preserve each adjustment. Recalculate when the care pattern or workforce position changes.

  1. 01

    Choose the planning window and operating area

    Define the dates, service, branch or zone and time bands being tested. Use a short operational horizon for rota decisions and a longer horizon for recruitment, training and growth.

  2. 02

    Convert care into worker-hours

    Total each planned visit at its assessed duration. Multiply double-up time by the number of workers required and keep time-critical windows visible instead of spreading demand evenly across the day.

  3. 03

    Add travel and required non-contact work

    Use realistic route travel, handovers, care-record completion, coordination and other work needed to deliver the service. Do not treat travel between assignments as spare capacity.

  4. 04

    Add a named contingency allowance

    Set and record the provider’s evidence-based allowance for predictable disruption such as short-notice absence, overruns and urgent changes. A buffer is a planning control, not proof that every risk is covered.

  5. 05

    Build gross supply from confirmed availability

    Use availability for the same dates, time bands and areas. Distinguish contracted hours, additional hours a worker has actually agreed and agency or bank cover that is genuinely confirmed.

  6. 06

    Remove unavailable and non-deployable time

    Subtract leave, known absence, training, supervision, meetings and other committed work. Apply working-time and rest constraints, then remove time that cannot be used because competence, authorisation, restrictions, transport or location do not match.

  7. 07

    Test peak, skill, geography and continuity

    Compare demand and capacity within each material time band and area. Check medicines, delegated activities, moving and handling, double-up calls, language or communication needs and the familiar worker team around each person.

  8. 08

    Resolve the gap without weakening the care plan

    Use safe options such as confirmed cover, recruitment, training, different worker availability or a discussion with the person and commissioner about an agreed change. Do not shorten, move or remove care only to make the arithmetic fit.

  9. 09

    Approve, monitor and trigger review

    Record the decision owner, assumptions, residual risk and review date. Recalculate after new packages, changed needs, leave, sickness, restrictions, incidents, missed visits, recruitment changes or repeated overtime.

Worked example

Worked example: enough weekly hours, not enough morning capacity

This illustrative review shows why a headline total is only the first test. All figures are synthetic planning inputs, not a staffing ratio or legal safe minimum.

Scenario

A branch reviews one locality for next week before accepting another morning care package. The planning window covers all paid and operational work needed to deliver the current visits.

Care demand
24 worker-hours of single-worker visits plus 4 additional worker-hours for double-up calls = 28 worker-hours.
Travel and support work
Add 5 hours of route travel, 2 hours for handovers and records, and a documented 3-hour contingency allowance. Total demand = 38 hours.
Gross worker supply
Confirmed availability in the locality totals 50 hours. This includes only contracted hours and additional availability workers have agreed for the week.
Usable capacity
Subtract 5 hours of leave or known absence, 3 hours of training and supervision, and 2 hours that cannot be deployed because of timing or restrictions. Usable capacity = 40 hours.
Headline position
40 usable hours less 38 demand hours = 2 hours of apparent headroom. At weekly level the branch appears covered.
Peak and skill test
Between 07:00 and 10:00, demand is 16 worker-hours but matching capacity is 13. Two time-critical medicines visits also require an authorised worker. The real decision is a 3-hour morning gap, not a 2-hour surplus.
Management decision
Do not accept the additional morning package yet. Seek suitable confirmed cover, adjust availability or agree a person-led service change through the proper process; record the owner and review date.

A percentage buffer is not set by CQC or NICE. Choose it from your own absence, overrun, travel and exception evidence, and test whether the reserved capacity is usable at the point of risk.

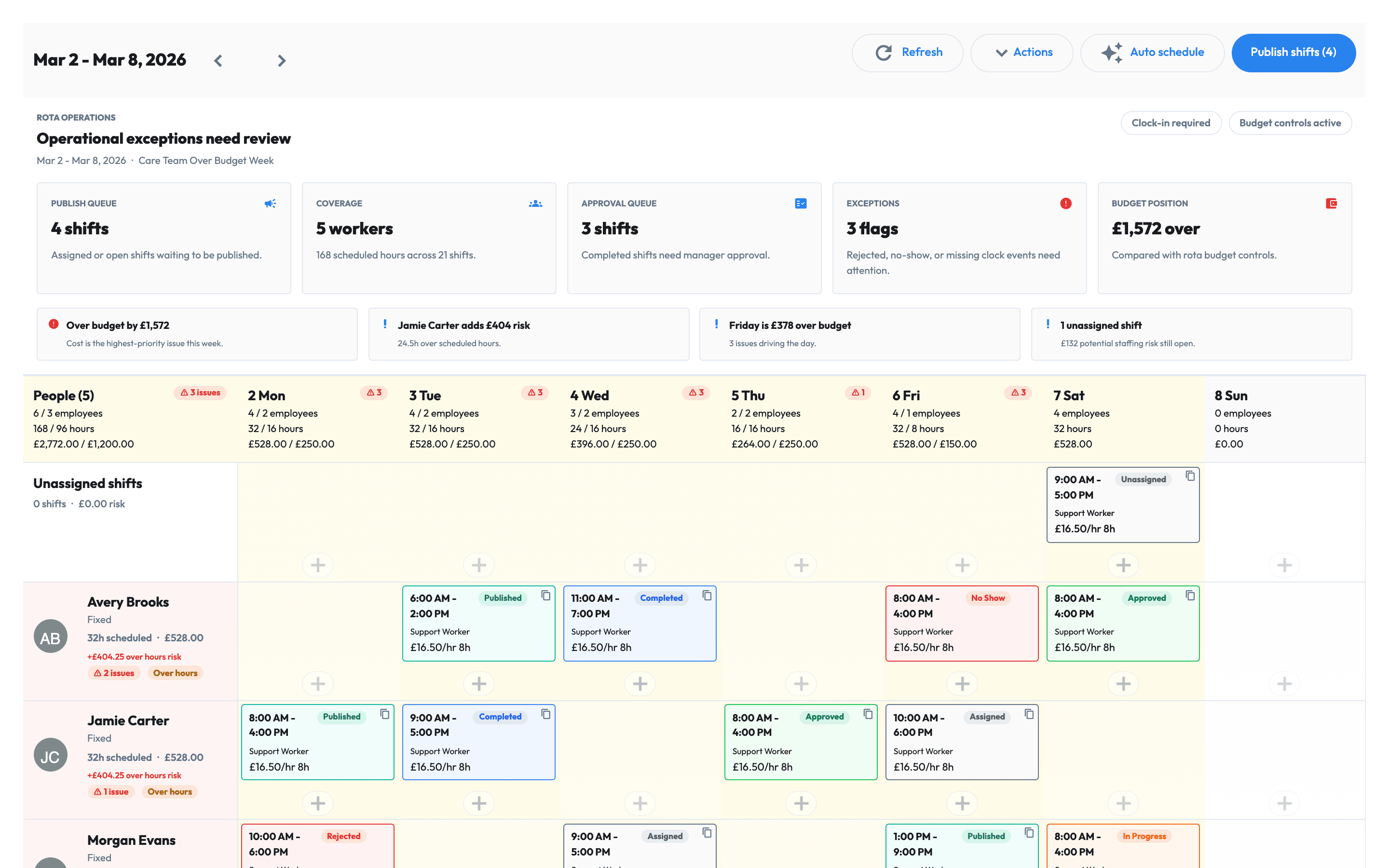

Weekly care coverage view showing staffing and budget pressure
Review pressure by time band and geography before a weekly total hides an unsafe gap. Select the image to inspect it at full size.

Printable working template

Care demand and usable-capacity review record

Print this page or use these fields in your operating record. Complete one record for each material planning window and area.

Planning scope

  • Service, branch or locality
  • Dates and named time bands
  • Prepared by, reviewed by and decision date
  • Trigger: routine review, new package or changed risk

Demand calculation

  • Visit worker-hours, including the extra worker on double-up calls
  • Travel between assignments and realistic route assumptions
  • Handovers, records, coordination and other required work
  • Contingency allowance, method and evidence used
  • Total demand by time band, geography and required skill

Capacity calculation

  • Confirmed gross availability for the same window
  • Leave, absence, training, supervision and committed work deducted
  • Working-time, rest, transport and location constraints applied
  • Competence, authorisation, restriction and continuity filters applied
  • Usable capacity by time band, geography and required skill

Decision and follow-up

  • Gap or headroom, including the peak-time result
  • Options considered and people consulted
  • Approved action, owner and deadline
  • Residual risk and contingency arrangement
  • Review date and event-triggered review conditions

Do not use this record as a fixed staffing ratio. Link it to current care plans, worker status, rota evidence and the management decision.

Practical checklist

Care-worker demand and capacity checklist

Complete these checks before treating the workforce as able to deliver the plan.

  • The planning dates, locality and time bands are explicit
  • Demand starts with current assessed care and support needs
  • Visit duration is counted as worker-hours, with double-up time multiplied correctly
  • Time-critical and flexible visits remain distinguishable
  • Travel uses realistic routes and is not treated as spare time
  • Handovers, records, coordination, training and supervision are visible
  • The contingency allowance has a stated method and evidence base
  • Supply uses confirmed availability rather than headcount or assumed overtime
  • Leave, absence and other committed work are deducted once and clearly
  • Working-time, rest, contract and policy constraints have been checked
  • Competence, authorisation and current restrictions are applied
  • Transport, location, continuity and person-worker suitability are tested
  • The peak-time result is reviewed separately from the weekly total
  • A named manager owns every unresolved gap and contingency action
  • No care is shortened or moved merely to make the capacity figure fit
  • Changes, assumptions, approval and the next review trigger are recorded

Keep the demand-to-decision evidence chain

  • Planning window, locality, service and time-band definitions
  • Current care plans, visit durations, time windows and double-up requirements
  • Travel assumptions, route evidence and required non-contact work
  • Contingency method and the operational evidence supporting it
  • Worker availability, agreed additional hours, leave and absence
  • Training, supervision, meetings and other committed work
  • Working-time, rest, contract and policy checks
  • Current competence, authorisation, restrictions and transport status
  • Demand and usable-capacity totals by time, geography and skill
  • Options considered, consultation and the approved response
  • Residual risks, contingency owner and escalation route
  • Review date, trigger events and evidence of the next recalculation

Where care capacity calculations fail

Headcount is treated as capacity

The provider counts employed workers without checking when, where or for what work they can actually be deployed.

Double-up care is counted once

A one-hour visit requiring two workers is recorded as one worker-hour, creating a hidden one-hour shortage.

Travel disappears between visits

The rota uses every minute for contact time even though workers must move safely between people’s homes.

A weekly surplus hides a morning gap

Hours available later in the day are used to offset time-critical demand that occurs at breakfast or bedtime.

Availability bypasses suitability

A free worker is treated as interchangeable despite competence, authorisation, restrictions, continuity or person-specific needs.

The buffer becomes a magic number

A percentage is copied forward without checking absence, travel, overrun and exception patterns or whether the capacity is usable at the point of risk.

Growth is committed before the gap is resolved

A package is accepted on assumed recruitment, overtime or agency cover rather than confirmed deployable capacity.

Check the source

Current sources for staffing and working-time decisions

Reviewed 10 August 2026. The calculation in this lesson is an operational planning method, not a statutory staffing ratio. Apply current care plans, contracts, policies and individual circumstances.
